Renovation, run as production.
We plan and deliver renovation and capital improvement programs for multifamily and hospitality properties. We also evaluate renovation scope, cost, and execution requirements before acquisition or construction. ABC coordinates the scope, trade sequence, materials, and quality checks as one production system.
10 in productionof 14 work areas this building supports1 holding on a condition
- Occupied
- Ready
- In production
- Blocked
- Verified
- Turned over
Illustrative unit renovation program: work starts in groups sized to the building’s access, space, and operating constraints.
A renovation is not a list of trades.
Renovation cost and schedule depend on the work the building can support: verified scope and quantities, access and occupancy, material deliveries, and the number of areas that can operate at once.
These conditions affect one another. Restricted access can change the sequence, extend the schedule, and increase cost. ABC evaluates those dependencies before acquisition and plans around them during execution.
ABC builds the budget, schedule, and workflow around what the work requires.
Two markets. Support before the work begins.
ABC works with owners, asset managers, property managers, developers, and operators. Start with your property type, or with renovation due diligence if you are evaluating an acquisition or capital plan.
Multifamily
Unit renovations and capital improvements.
Unit renovation and capital improvement programs across a property or portfolio, including vacant and occupied work, pilot programs, and full repositioning.
Read about MultifamilyHospitality
Renovation around an operating asset.
Guestroom and common-area renovations planned around occupancy and hotel operations. Where the property stays open, rooms are taken out of service in planned blocks, with protected guest access and coordinated efficiency upgrades where appropriate.
Read about HospitalityGuestroom and common-area programsRenovation Due Diligence
Know what the renovation will actually take.
Pre-acquisition renovation assessment and preconstruction analysis to test the proposed scope, budget, and timeline against the property and the work required.
Read about Renovation Due DiligencePre-acquisition assessment and preconstruction
The conditions change. The discipline does not.

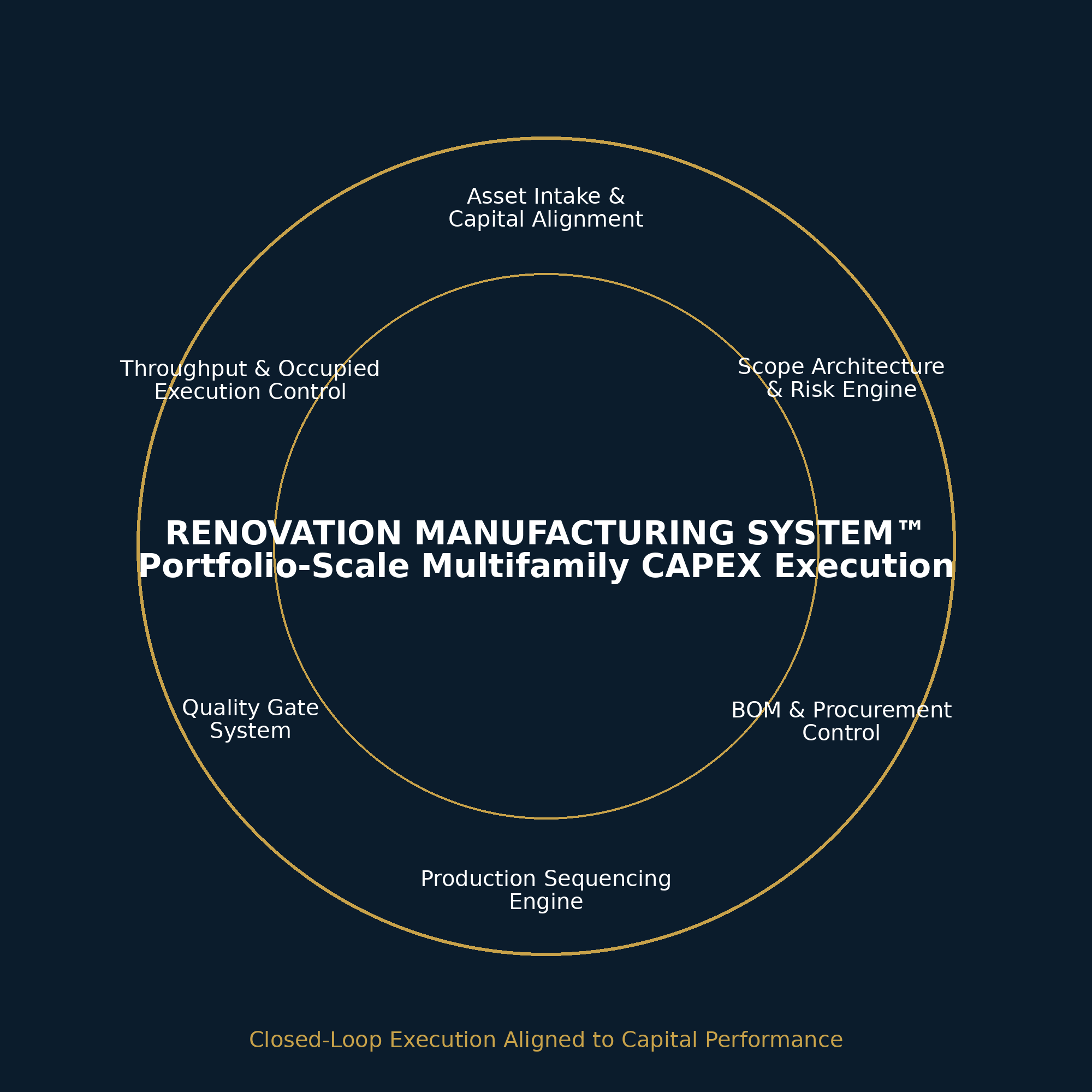

ABC uses the Renovation Manufacturing System™ (RMS) to define the work, confirm readiness, coordinate the sequence, and verify quality as the program advances.
RMS does not standardize the conditions. It standardizes how ABC responds to them.
What it standardizes
- 01
Readiness before work starts
- 02
Quality checks between activities
- 03
Planned and actual progress
Capacity is not the number of people on site.
Capacity is the amount of work that can start, proceed, and finish with the access, materials, trade coverage, and quality checks it needs. ABC plans capacity around the required volume and timeline.
Additional labor can increase output when work is ready and space is available. If access, materials, or another constraint limits progress, more people can add cost without increasing production.
Speed is not the starting point. It is the result of a better-controlled process.
Control should be visible.
You should not have to wait until the end to know whether the program is under control.
As the program runs, the client should be able to understand what is ready, what is in production, what is verified, what is blocked, and what requires a decision. Where a condition changes the plan, the board says why, and what happens next.
Conditions change during renovation. The owner needs to see the issue, its effect on the plan, and the decision or action needed.
Five units from an illustrative program
Every unit is Completed, In Progress or On Notice. Anything else about it is a condition, written beside the status.
Illustrative
- 5 units
- 1 Completed
- 3 In Progress
- 1 On Notice
- 1 blocked
- 2 late
- 1 ahead
- 1 resequenced
- 1 decision open
| Unit · status · conditions | Notice | 1 Demolition | 2 Rough-in | 3 Wall preparation | 4 Paint | 5 Cabinets and countertops | 6 Flooring | 7 Fixtures and trim | 8 Appliances and final connections | 9 ABC Verification | 10 Client Punch | Complete |
|---|---|---|---|---|---|---|---|---|---|---|---|---|
Unit 101Completed
| Aug 3received | ✓D1–2Aug 17–18 | ✓D3–4Aug 19–20 | ✓D4–5Aug 20–21 | ✓D6Aug 24 | ✓D7–8Aug 25–26 | ✓D7–9Aug 25–27 | ✓D9–10Aug 27–28 | ✓D10Aug 28 | ✓D11Aug 31 | ✓D12Sep 1 | ✓Sep 1complete |
Unit 104In Progress
| Aug 3received | ✓D1–2Aug 17–18 | ✓D3–4Aug 19–20 | ✓D4–5Aug 20–21 | ✓D6–7Aug 24–25 | ‖D8–14NowAug 26–Sep 3 | ✓D8–10Aug 26–28 | ✓D10–11↺Aug 28–31 | ‖D11–14↺Aug 31–Sep 3 | D15Sep 4 | D15Sep 4 | Sep 4projected · late +2 days |
Unit 105In Progress
| Aug 10received | ✓D1–2Aug 24–25 | ✓D3–4Aug 26–27 | ✓D4–5Aug 27–28 | ✓D6–7Aug 31–Sep 1 | ▸D8–9NowSep 2–3 | ▸D8–10Sep 2–4 | D10–11Sep 4–8 | D11Sep 8 | D12Sep 9 | D13Sep 10 | Sep 10projected |
Unit 202In Progress
| Aug 10received | ✓D1–2Aug 24–25 | ‖D3–10NowAug 26–Sep 4 | D10–11Sep 4–8 | D12–13Sep 9–10 | D14–15Sep 11–14 | D14–16Sep 11–15 | D16–17Sep 15–16 | D17Sep 16 | D18Sep 17 | D19Sep 18 | Sep 18projected · late +6 days |
Unit 302On Notice
| Aug 18ready | D1–2Sep 3–4 | D3–4Sep 8–9 | D4–5Sep 9–10 | D6–7Sep 11–14 | D8–9Sep 15–16 | D8–10Sep 15–17 | D10–11Sep 17–18 | D11Sep 18 | D12Sep 21 | D13Sep 22 | Sep 22planned |
D = working day since that unit started✓ complete▸ in progress‖ held↺ resequencedplain = planned
Explore the full illustrative program on the Project Demo page. Open units and activities to see their detail and how questions connect to the work.
See how we would organize the work.
Tell us about the property, intended scope, and target timeline. We will explain what needs verification, what must be ready before work starts, and which decisions and risks need attention first.
Before you award the work
See how ABC would organize your program.
A private Project Demo of how ABC would organize and control a program like yours, prepared after review.
Request a Project Demo
